We are attempting to update the status date in the sub-projects of a Schedule using VBA following the suggestions
Alternatives that also have not worked.
- We've tried setting
Projects(subp.SourceProject.Name).StatusDate:
If ActiveProject.Subprojects.count > 0 Then
Dim msg: msg = MsgBox("Change Status Date for unopened Subprojects?", vbYesNo, "Change Status Dates for Unopened Subprojects?")
Dim subp As SubProject
If msg = vbYes Then
Application.StatusBar = "Updating Sub-Projects..."
For Each subp In ActiveProject.Subprojects
Projects(subp.SourceProject.Name).StatusDate = newDate
subp.SourceProject.SaveAs subp.SourceProject.Name
Next
End If
End If
- We've tried to open the sub-projects first and then to change the value (we've tried both FileOpen & FileOpenEx):
If ActiveProject.Subprojects.count > 0 Then
Dim msg: msg = MsgBox("Change Status Date for unopened Subprojects?", vbYesNo, "Change Status Dates for Unopened Subprojects?")
Dim subp As SubProject
If msg = vbYes Then
Application.StatusBar = "Updating Sub-Projects..."
For Each subp In ActiveProject.Subprojects
FileOpen subp.SourceProject.Path
subp.SourceProject.StatusDate = newDate
FileClose pjSave
Next
End If
End If
- And then we've tried saving the sub-projects in various ways using:
subp.SourceProject.SaveAs subp.SourceProject.NameProjects(subp.SourceProject.path).SaveAs subp.SourceProject.Name
As an interesting data point, we do notice that both the SourceProject.StatusDate and Projects(subp.SourceProject.Name).StatusDate for a given sub-project are what we set them to, even if the sub-project, once opened in MSP, does not reflect the value in the interface.
Note: we have tried closing/re-opening and manual save all (user input). No go.
Any suggestions are more than welcome.
EDIT #1
Note that we have also attempted saving the master schedule following the loop using two methods.
First, code leading up to the save:
'save name of Master Schedule to imsProj
dim imsProj as string: imsProj = ActiveProj.Name
If ActiveProject.Subprojects.count > 0 Then
'Here is where we run the above loop
End If
'Ensure the Master Schedule is the active project
Projects(imsProj).Activate
'Master Schedule save goes here. See below.
Then:
Save Method 1
'Save all open Projects, including master
For i = 1 To Projects.count
Projects(i).SaveAs Projects(i).Name
Next i
Save Method 2:
FileSave
Neither works.

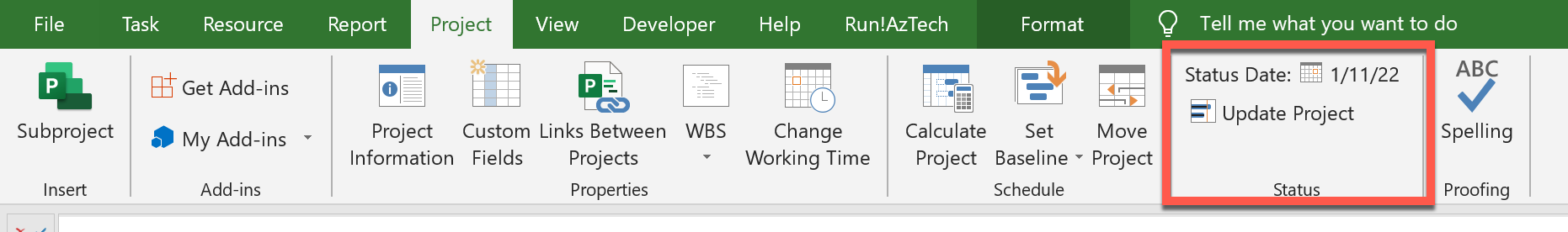

Is there a setting in MSP that we are not considering?
CodePudding user response:
Instead of trying to save each subproject individually, save the entire master at the end. Turning of alerts prevents a pop-up confirmation box for each subproject.
Sub SetSubProjectStatusDate()
Dim newDate As Date
newDate = #1/11/2022#
If ActiveProject.Subprojects.Count > 0 Then
Dim msg As VbMsgBoxResult
msg = MsgBox("Change Status Date for unopened Subprojects?", vbYesNo vbQuestion _
, "Change Status Dates?")
If msg = vbYes Then
Application.StatusBar = "Updating Sub-Projects..."
Dim subp As Subproject
For Each subp In ActiveProject.Subprojects
subp.SourceProject.StatusDate = newDate
Next
DisplayAlerts = False
FileSave
DisplayAlerts = True
End If
End If
End Sub
CodePudding user response:
This is incredibly frustrating, but it appears the IMS and its subprojects were somehow corrupted. No evident cause, no evident effect other than with how the status dates appear. Using a fresh set of MPPs resolved the matter.
Here is the final working code:
If ActiveProject.Subprojects.count > 0 Then
Dim msg: msg = MsgBox("Change Status Date for unopened Subprojects?", vbYesNo, "Change Status Dates for Unopened Subprojects?")
Dim subp As SubProject
If msg = vbYes Then
Application.StatusBar = "Updating Sub-Projects..."
For Each subp In ActiveProject.Subprojects
subp.SourceProject.StatusDate = temp
Next
End If
End If
Projects(imsProj).Activate
FileSave
